Norfolk, VA (Portlock) Terminal Paving Project

ATLANTA, GA

We would like to inform you of a scheduled pavement improvement project at our Norfolk, VA (Portlock) Intermodal Facility. The project is expected to begin Tuesday, August 18, 2026, and is expected to be completed by Wednesday, November 25, 2026.



To minimize operational impacts, the project will be completed in multiple phases. During the time the main crossing is replaced (Phase 1B), the secondary crossing behind RH01 & RH02 will be accessible. For your reference, a map outlining each phase of the project is shown below.

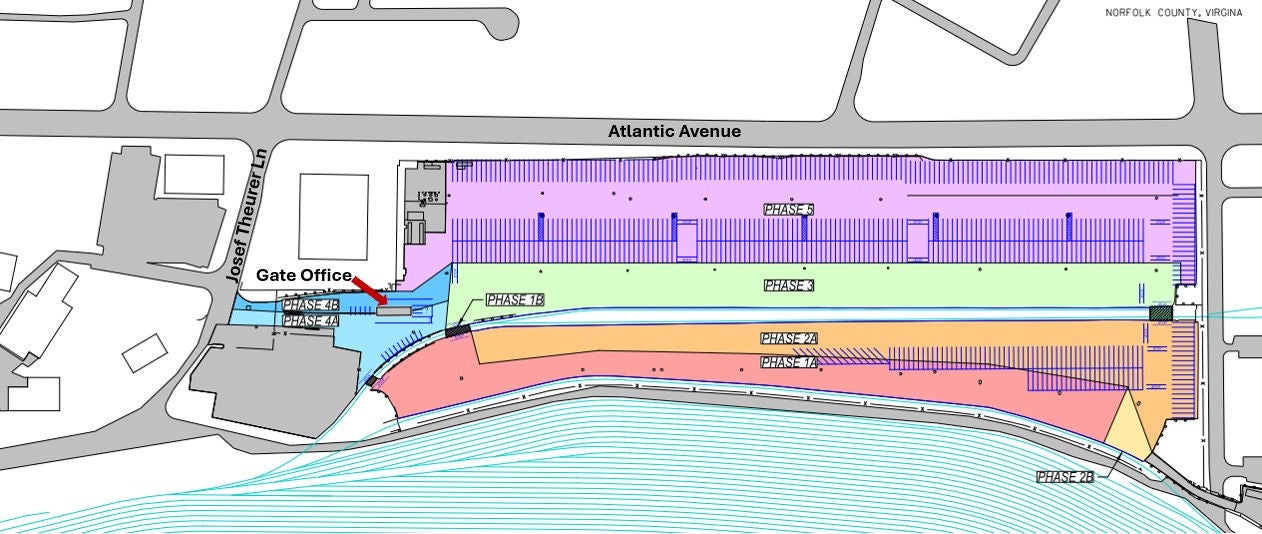

Norfolk VA Portlock Construction Map 08-14-2026

Project Schedule



August 18 – September 7

  • Phase 1A – Lot TS03
  • Phase 1B – Main Crossing



September 9 – September 29

  • Phase 2A – Lot TS02, to include Lot 45A, this will restrict access to Lot 4D
  • Phase 2B – Entrance to Lot 4D (rear lot)



September 30 – October 23

  • Phase 3 – TS01, this will restrict access to Lot 45A



October 23 – November 10

  • Phase 4A – Inbound Entrance, we will use the outbound lane as an entrance and exit lane
  • Phase 4B – Outbound Entrance, we will use the inbound lane as an entrance and exit lane



October 28 – November 25

  • Phase 5 – Lot 53 & Lot 20



During construction, traffic patterns and access routes may be temporarily adjusted within the terminal. We ask that all drivers and visitors follow posted signage and the directions of on-site personnel to ensure everyone’s safety, and to help maintain efficient terminal operations.



No shipment departure or availability delays are expected during the project. We appreciate your patience and cooperation as we complete these improvements. Updates will be provided if the schedule changes due to weather or other unforeseen circumstances.
